Kerner Boulevard Redevelopment Project

Marin Transit is in the process of a redevelopment project on Kerner Boulevard in San Rafael, CA. In 2022 we opened a vehicle maintenance facility for our demand-response fleet. Currently, we are working on an adjacent project which will eventually be combined into an integrated parking, maintenance, and electric vehicle charging facility for our demand response fleet.

The ongoing project at 3010 & 3020 Kerner will demolish the existing office structures and make minor improvements to the site, including installation of a solar panel canopy, electric vehicle charging infrastructure, paving, parking lot striping, perimeter fencing, an electronic  gate, and lighting improvements for security.

  • Phase 1: Demolition of existing buildings (completed)
  • Phase 2: Construction of parking facility and charging infrastructure (in progress)

Follow progress with our monthly newsletter below!

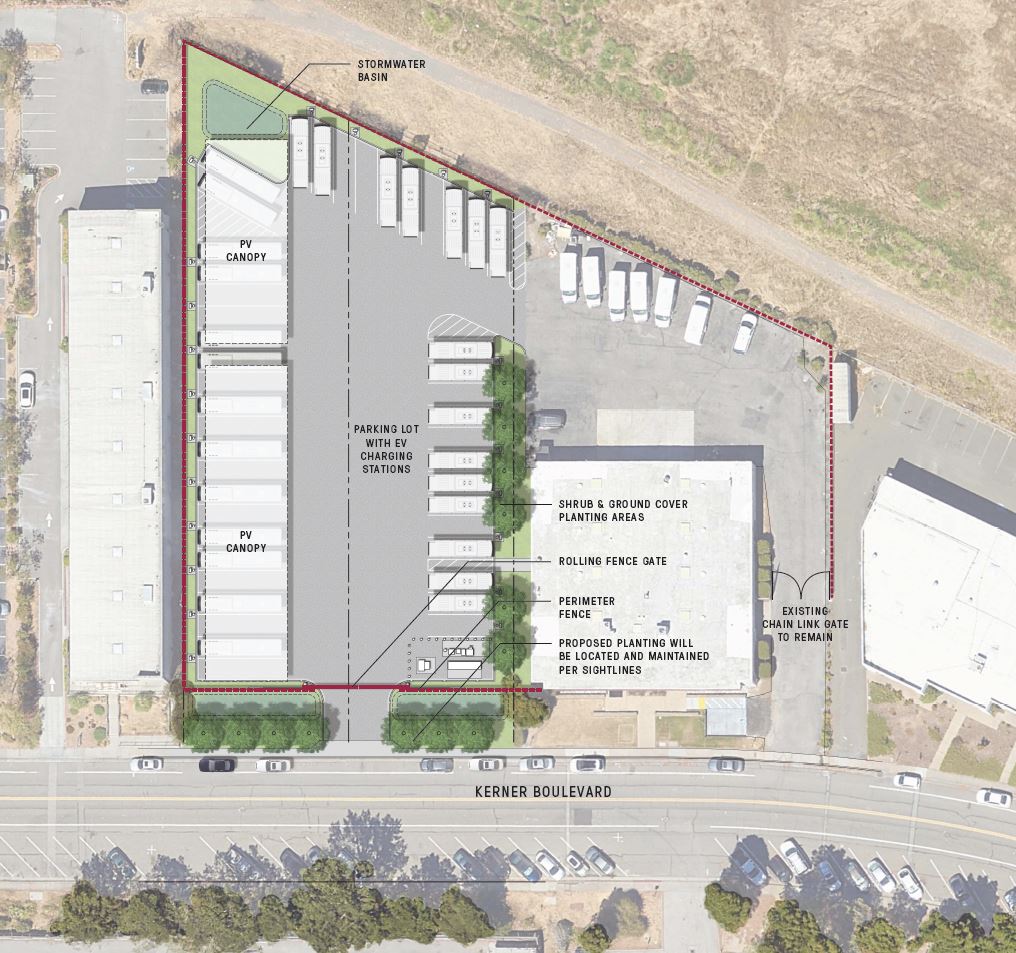

An image of the plans for the 3010/3020 Kerner lot. It includes a solar canopy on the left hand side, a parking lot with EV charging stations, and proposed fencing and landscaping for the site.



Paved parking lot with solar panel canopies

Construction Notice

Marin Transit will conduct pile driving at 3010 Kerner Blvd that will cause potential noise and vibrations. Anticipated times for Pile Driving will be between 9am - 3pm on three weekdays.

  • *9/8/25 - approx. 30-60 minutes of pile driving - Completed
  • 9/15/25 - 9/16/25 - 9am - 3pm potential pile driving - Completed

Current Schedule

March 2025

  • Construction begins & site set-up/surveying Completed
  • Tree & Curb removal (private right of way) Completed

June 2025

  • Storm drain and catch basin construction Completed
  • Installing underground conduit Completed

July 2025

  • Continue Installing underground conduit Completed
  • Light construction & installation Completed
  • Parking Lot Foundation installation Completed

August 2025

  • Continue Light construction & installation Completed
  • Parking lot construction Completed
  • Landscaping & Irrigation In Progress

September 2025

  • Solar canopy construction begins Completed
  • Structural steel installation Completed
  • Light construction & installation Completed
  • Landscaping & Irrigation In Progress

October 2025

  • Initial Parking Lot Paving Completed
  • Structural steel installation Completed
  • Continued solar canopy construction Completed
  • Energy storage installation & electrical work Completed
  • Switchgear for parking lot arrival and installation Completed
  • Light construction & installation Completed
  • Landscaping & Irrigation In Progress

November 2025

  • Light construction & installation Completed
  • Solar canopy electrical work Completed
  • Landscaping & Irrigation In Progress

December 2025

  • PG&E energization of parking lot Completed
  • Install EV Charger On Hold
  • Landscaping & Irrigation In Progress
  • Light construction & installation Completed

January 2026

  • Sidewalk and driveway construction (public right of way) Completed
  • Landscaping & Irrigation In Progress
  • Install EV Charger On Hold
  • Light construction & installation Completed

February 2026

  • Install gates/fencing In Progress
  • Landscaping & Irrigation In Progress
  • Install EV Charger On Hold

March 2026

  • Install gates/fencing In Progress
  • Landscaping & Irrigation In Progress
  • Install EV Charger On Hold
  • Final Parking Lot Paving
  • Striping
  • Delivery of electrical equipment
  • Delivery and installation of Switchgear for building at 3000 Kerner

April 2026

  • Delivery of electrical equipment
  • PG&E tie in to 3000 Kerner

May 2026

  • Back-up battery system completion
  • Project completion.

Upcoming Meetings & Events

There are currently no upcoming meetings or events

Past Meetings & Events

There are currently no upcoming Advisory Committee Events

News

There is currently no project news.
